Project Management

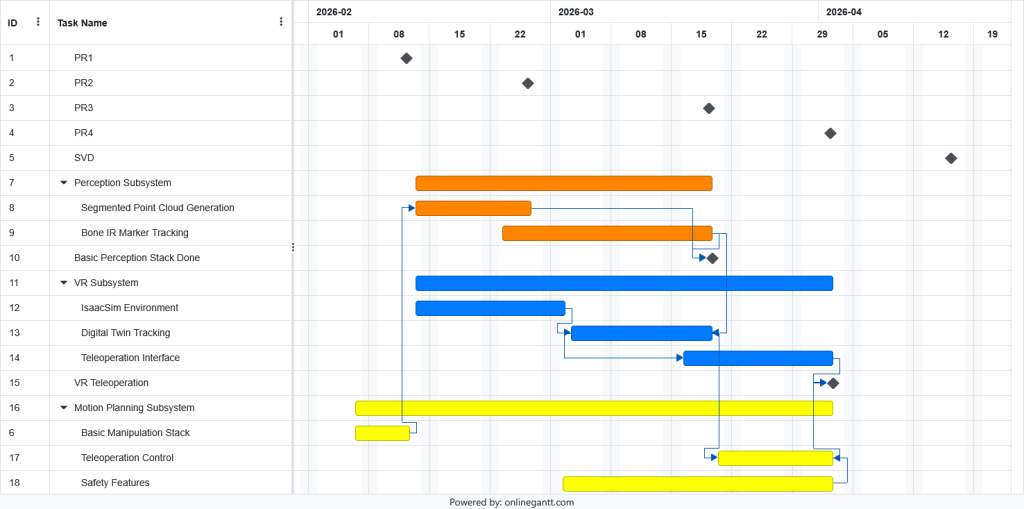

Spring Gantt Chart

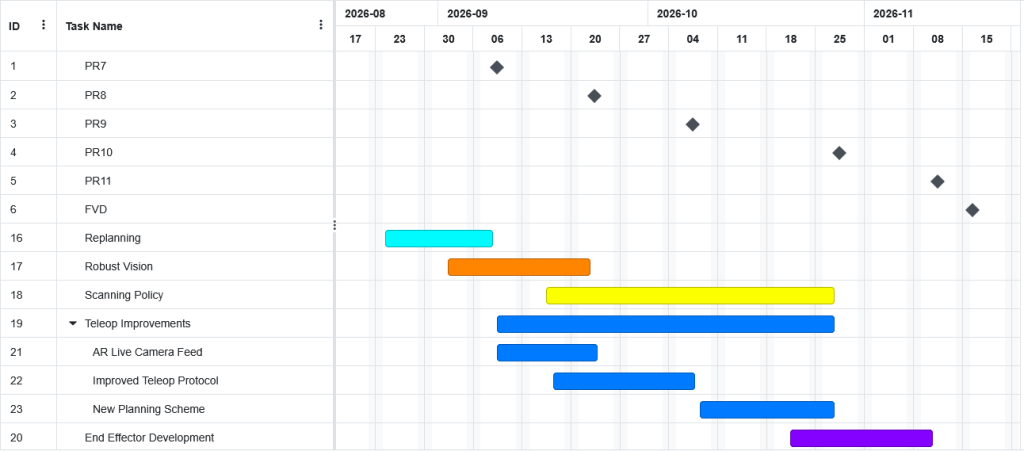

Fall Gantt Chart


Presenters

Spring:
Sensors and Motors Lab: Shubh Jain
PR01: Aayush Agrawal
PR02: Shreenabh Agrawal
PR03: Gabriel Zaragoza
PR04: Shubh Jain

Fall:
PR07: Shubh Jain
PR08: Gabriel Zaragoza
PR09: Shreenabh Agrawal
PR10: Shubh Jain
PR11: Gabriel Zaragoza


Test Plan

Spring Test Plan

SVD Plan

Fall Test Plan

FVD Plan


Parts List

Our main spending for the project:

Subsystem Hardware: $440

  • Logitech Muse Spatial Controller, 2 Adafruit foot switches, 2 Raspberry Pi Zero, Studio Lights + Stand

Software & Operations: $129

  • Apple Developer License, surgery drape sheets

Provided by Sponsor/Past Teams

  • KUKA LBR Med 7 Cobot, Apple Vision Pro headset, Polaris IR camera and tracker arrays, RTX 4070 workstation computer

Issues Log

Team B Issues Log


Risk Management

IDRiskReq.TypeLCMitigation
R1Registration accuracy
below medical grade
PR1,
PR6
Technical04Atracsys ground truth setup operational;
YOLO 2D pipeline replaces SAM; ICP with iterative refinement
R2Mis-drill of bone by
robot end effector
PR5,
NFR2
Safety25Dry-run cycles without tool rotation;
virtual safe zones + geofencing; force monitoring; physical + software E-stop
R3S+N drill handpiece
incompatible with KUKA
FR3.1Technical34Software integration first; fallback to
simple drill with robot pose/feed control
R4Teleoperation latency
exceeds safe threshold
PR9,
FR4.1
Technical34Local network testing first; command buffering
protocol; latency monitoring with auto-halt
R5System integration
delays across subsystems
NFR1Schedule04Defined ROS2 interfaces; weekly integration
checkpoints; parallel development tracks
R6IR tracking drift during
extended procedure
PR1,
PR3
Technical04EKF smoothing in pipeline; periodic re-calibration
checks; Atracsys as backup reference
R7Budget overrun from
bone model consumption
—Cost33Moldable surrogates for iterative testing;
anatomic models reserved for final validation
R8Drilling reliability under load – force, torqueFR6Technical34T11 bench characterization w/ force+torque telemetry; T12 force-monitored drilling on phantom; abort thresholds wired to software E-stop.
R9NFR-05 compliance gapNFR5Technical32T15 compliance-mapping checklist. Documentation only — not full certification (out of scope for academic project).
R10Cross-coordinate-frame bug recurrence with new EEFR2Technical23Static transform publisher with explicit checks; unit tests for each transform; behaviour tree for state management.
R11Team capacity decreaseN/AN/A44Re-scope discuss with Smith & Nephew Move repos to team org.
R12Knowledge continuityN/AN/A34Finalise Knowledge transfer document & context
R13New point cloud model decreases average accuracyPR15Technical23retain original pre-defined trajectory in system as fallback
R14End effector damagePR19Technical42manufacture more than one, design for pen replacement
R15AVP can’t efficiently render custom modelsPR17Technical34increase focus on improving network pipeline
L = Likelihood (1-5),
C = Consequence (1-5).
Scale: 1 = lowest, 5 = highest.

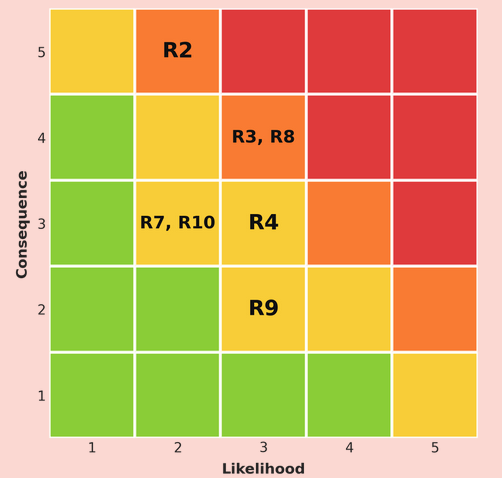

Risk Matrix
